App development · Real timelines

How long does it take
to build an app?

A simple app takes about 6–10 weeks to build, most first versions of a real product take 3–6 months, and complex apps — marketplaces, fintech, health — take 6–12 months. Add one to two weeks for app store approval and testing rules. Projects rarely slip because of coding speed; they slip on unclear scope, slow decisions and late testing.

By , FounderUpdated 7 min read

Share

Quick answer: How long does it take to build an app?

  1. Simple app or MVP (5–10 screens, one main flow) — 6–10 weeks.
  2. Typical first version of a product (e-commerce, learning, social) — 3–6 months.
  3. Complex apps (on-demand, fintech, health, marketplaces) — 6–12 months.
  4. Plus store time — Apple reviews most submissions within 48 hours; Google Play can take up to seven days, and new personal accounts must first run a 14-day closed test.

Key takeaways

  • Development is usually only about half the calendar. Discovery, design, testing and store approval take the rest.
  • The biggest delays come from changing scope mid-build and slow decisions, not slow developers.
  • New Google Play personal developer accounts need a 12-tester, 14-day closed test before production — plan it in from day one.
  • Adding people to a late project usually makes it later. Cut scope instead.
  • Fix the launch date and let the feature list flex, not the other way round.

Every agency proposal has a timeline, and almost every one of them is optimistic. Not because the people writing them are dishonest, but because the plan assumes the client decides quickly, the scope holds still and the first build passes review. None of those is a safe bet. Here are the timelines that survive contact with reality.

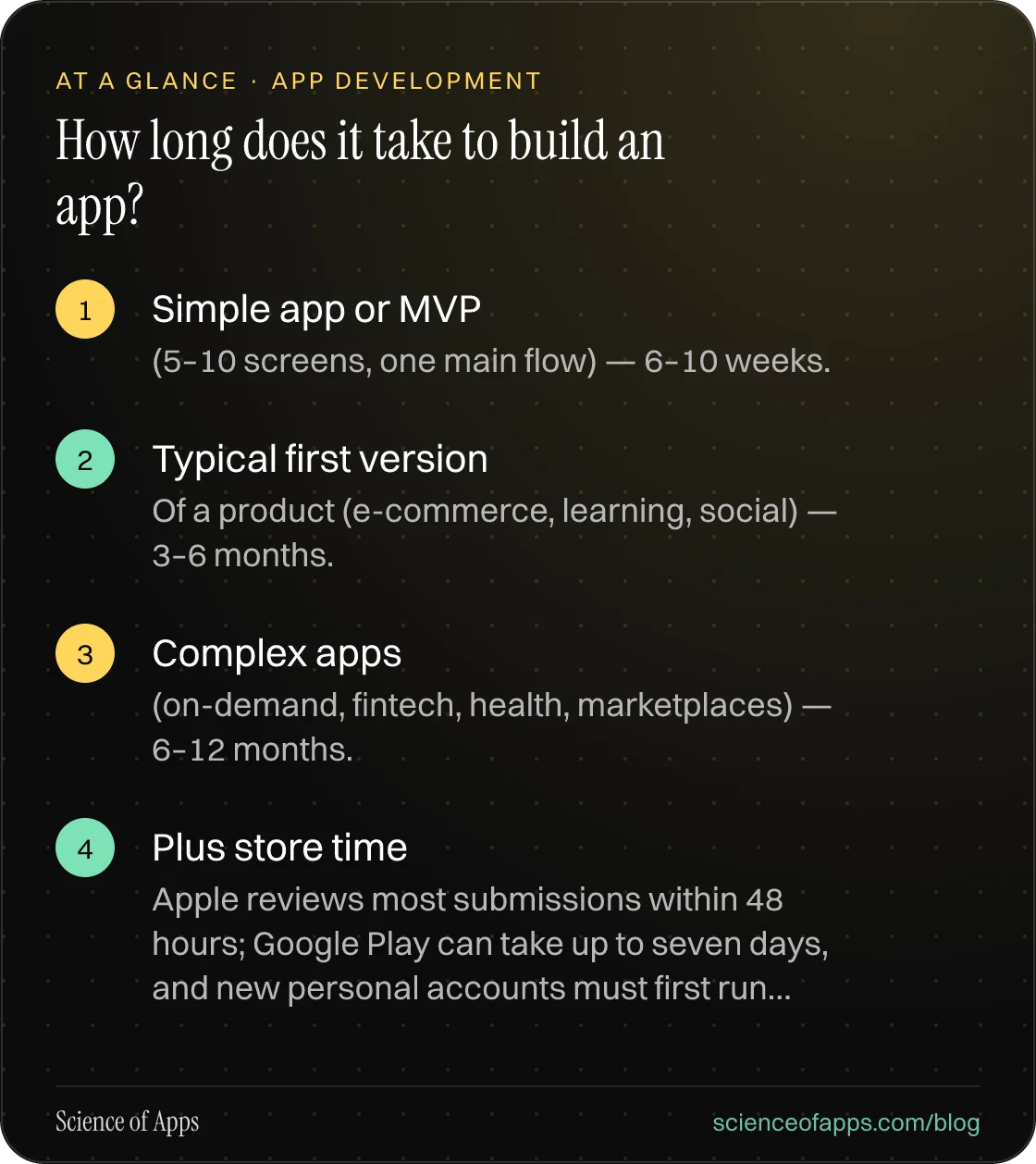

How long does it take to build an app? At a glance: Simple app or MVP; Typical first version; Complex apps; Plus store time.
At a glance: How long does it take to build an app?

The short answer: app timelines by type

How long it takes to build an app, by type (Science of Apps estimates for a first version built by an Indian team)
Type of appTypical first versionTimeline (design to store)
Simple MVP or utility5–10 screens, login, one core flow6–10 weeks
E-commerce or D2C storeCatalogue, cart, payments, orders, admin10–16 weeks
Edtech or learningVideo lessons, quizzes, progress, subscriptions14–26 weeks
Social or communityProfiles, feed, chat, media, moderation16–28 weeks
HealthtechConsultations, records, prescriptions, consent16–30 weeks
On-demand or deliveryCustomer, partner and operations apps, live tracking16–28 weeks
FintechKYC, payments, security, compliance20–40 weeks
AI-poweredModel APIs, retrieval, guardrails, evaluation10–24 weeks

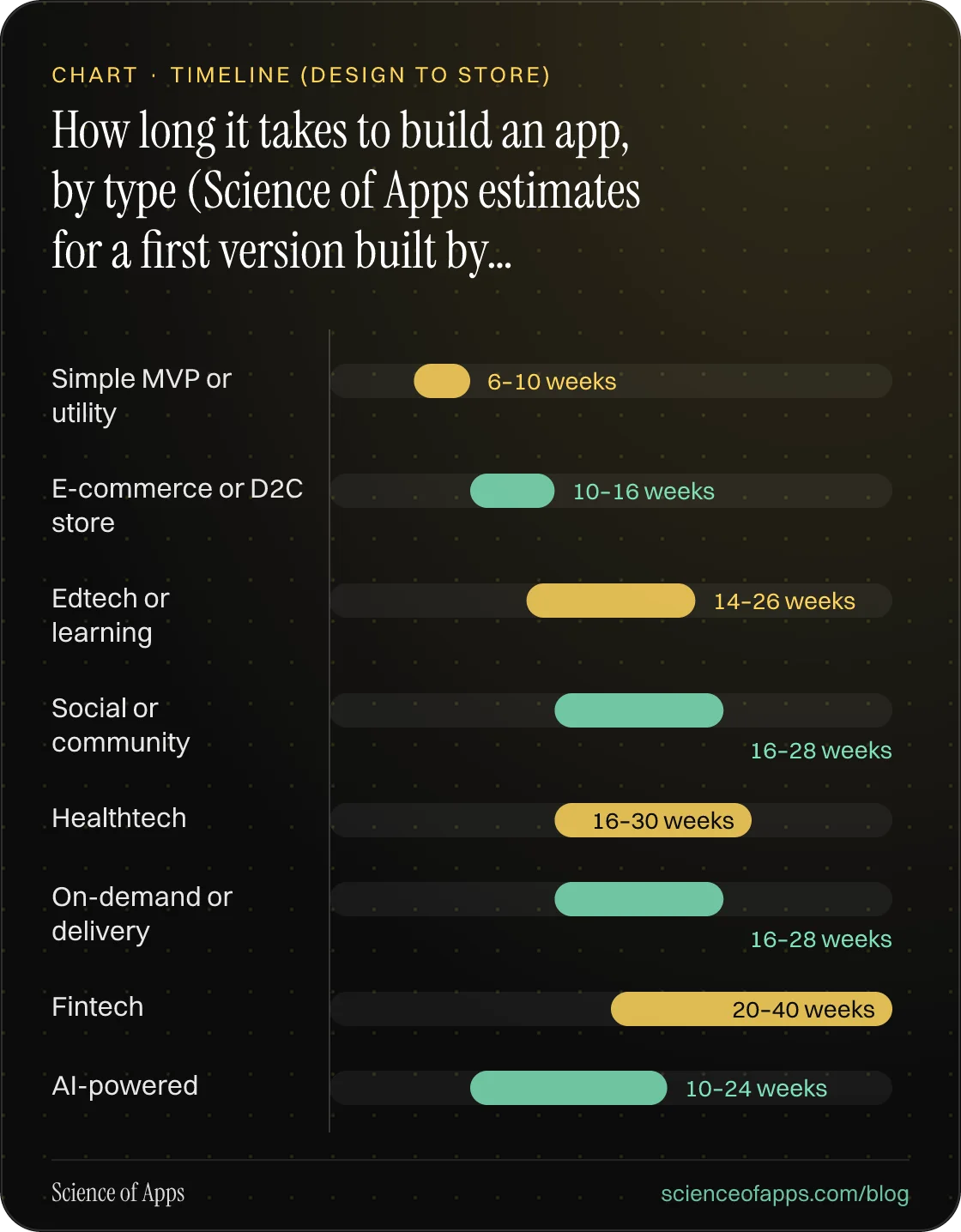

Bar chart: How long it takes to build an app, by type (Science of Apps estimates for a first version built by an Indian team) — Simple MVP or utility: 6–10 weeks; E-commerce or D2C store: 10–16 weeks; Edtech or learning: 14–26 weeks; Social or community: 16–28 weeks; Healthtech: 16–30 weeks; On-dema
How long it takes to build an app, by type (Science of Apps estimates for a first version built by an Indian team)

These match the timelines in our app development cost guide. The ranges are wide because scope varies more than anything else; the bottom of each range assumes decisions get made within a day or two.

Where the time actually goes

Writing code is usually about half the calendar. The rest is everything around it.

How an app project's timeline splits by phase
PhaseWhat happensShare of the calendar
DiscoveryUser interviews, competitor review, scope, the riskiest assumptions8–12%
UX and UI designFlows, wireframes, visual design, a clickable prototype, usability tests15–20%
DevelopmentApps, backend, admin panel, integrations45–55%
Testing and fixesReal devices, edge cases, performance, security12–18%
Store submission and launchListings, review, closed testing, staged rollout5–10%

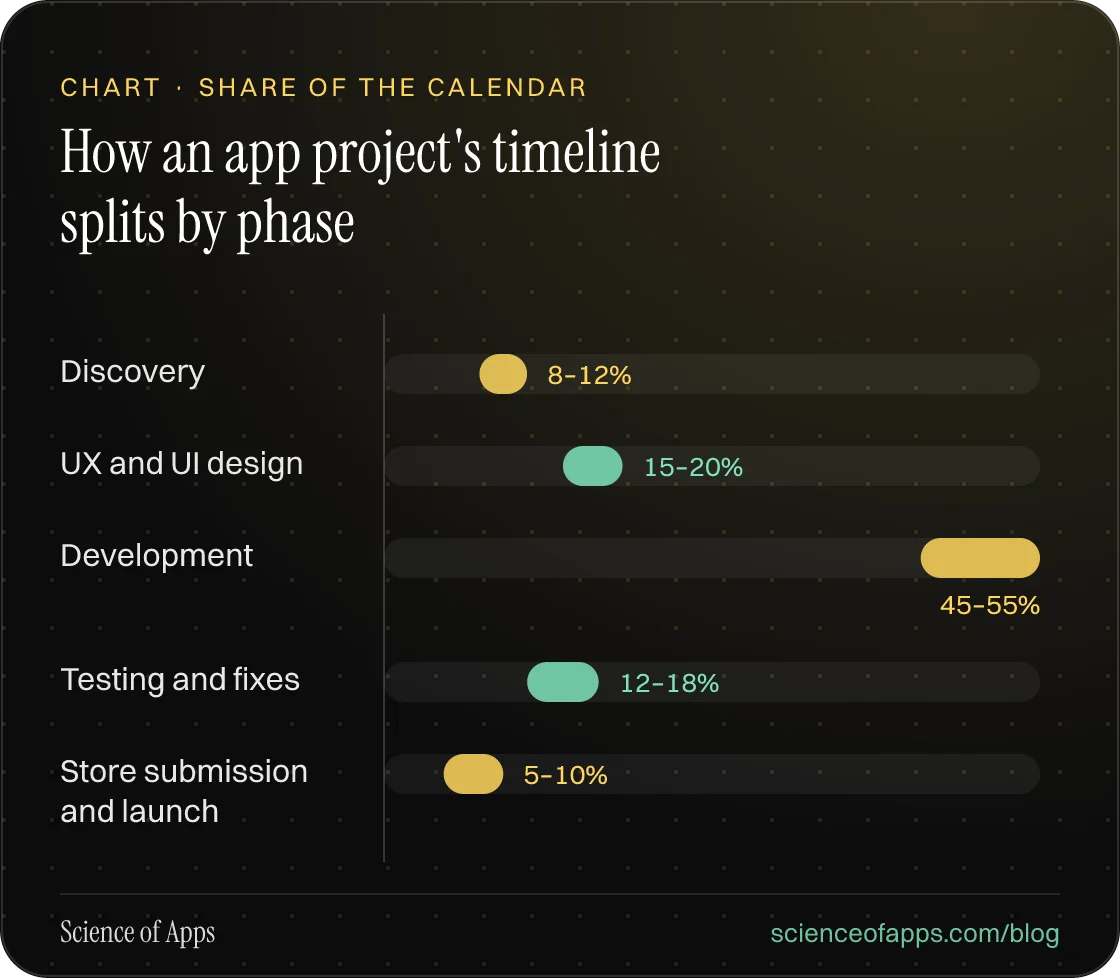

Bar chart: How an app project's timeline splits by phase — Discovery: 8–12%; UX and UI design: 15–20%; Development: 45–55%; Testing and fixes: 12–18%; Store submission and launch: 5–10%.
How an app project's timeline splits by phase

Design and development can overlap — developers start on the backend and the screens already approved — which is how good teams compress a schedule without cutting corners.

App store time: plan for it from day one

Store approval is short but unpredictable, and it is the most common reason a launch date slips at the last minute.

  • Apple says App Review typically reviews at least 50% of submissions in under 24 hours and 90% in under 48 hours1. A rejection resets the clock after you fix and resubmit.
  • Google Play says processing can take a few hours or up to seven days, longer in exceptional cases, and recommends at least a week's buffer between submitting and going live2.
  • New Google Play personal accounts must run a closed test with at least 12 testers who stay opted in for 14 continuous days before they can even apply for production access3. If you discover this in the last week, your launch moves by three.

Why app projects run late

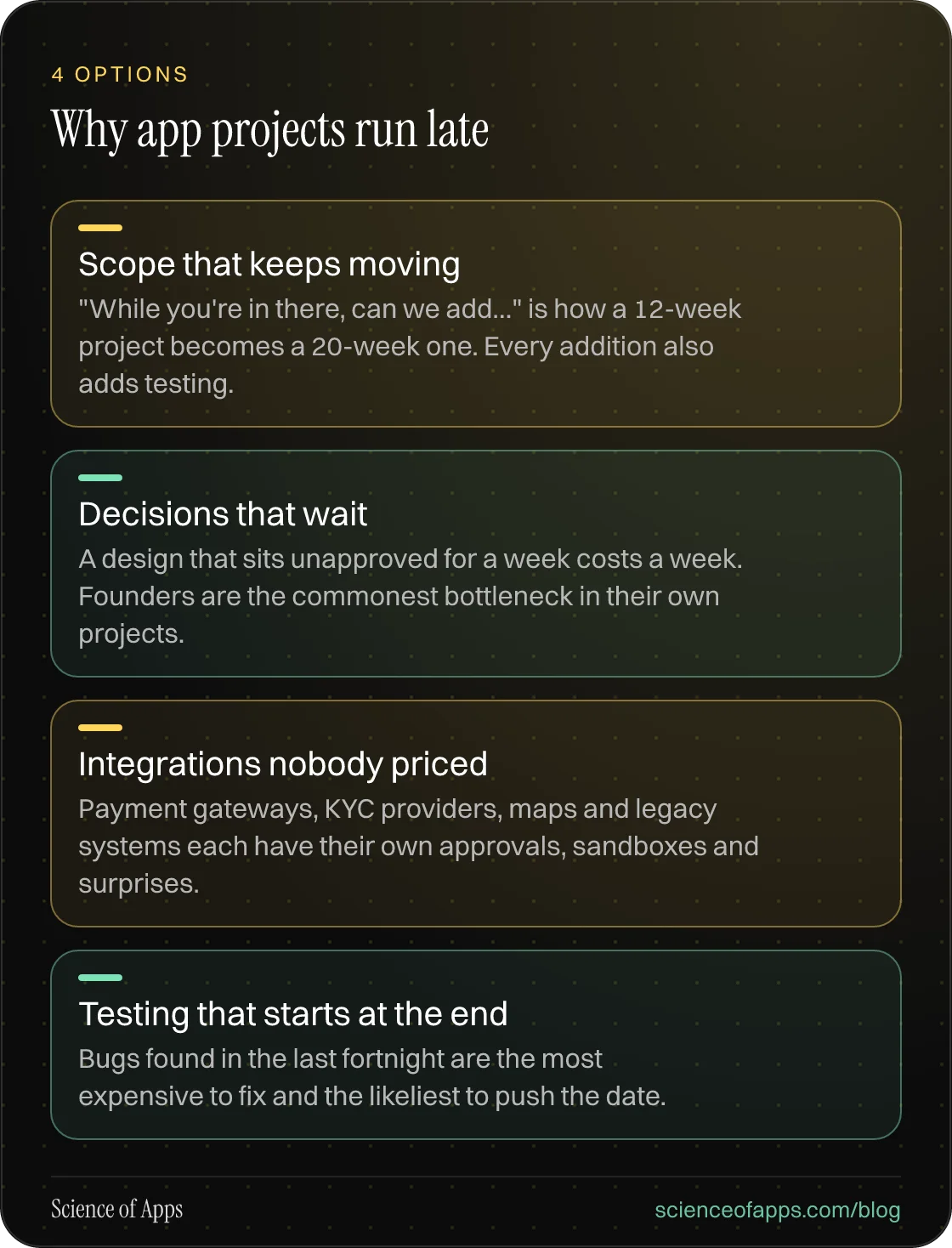

Why app projects run late: Scope that keeps moving; Decisions that wait; Integrations nobody priced; Testing that starts at the end.
Why app projects run late

Scope that keeps moving

"While you're in there, can we add…" is how a 12-week project becomes a 20-week one. Every addition also adds testing.

Decisions that wait

A design that sits unapproved for a week costs a week. Founders are the commonest bottleneck in their own projects.

Integrations nobody priced

Payment gateways, KYC providers, maps and legacy systems each have their own approvals, sandboxes and surprises.

Testing that starts at the end

Bugs found in the last fortnight are the most expensive to fix and the likeliest to push the date.

There is also a trap in the obvious fix. Adding developers to a late project tends to make it later, because new people need onboarding and coordination grows faster than output — an observation Fred Brooks made in 1975 that still holds4. When a project is late, cut scope.

And watch the opposite problem. Work expands to fill the time available — Parkinson's law — so a generous deadline with a loose scope rarely finishes early.

How to build an app faster without cutting quality

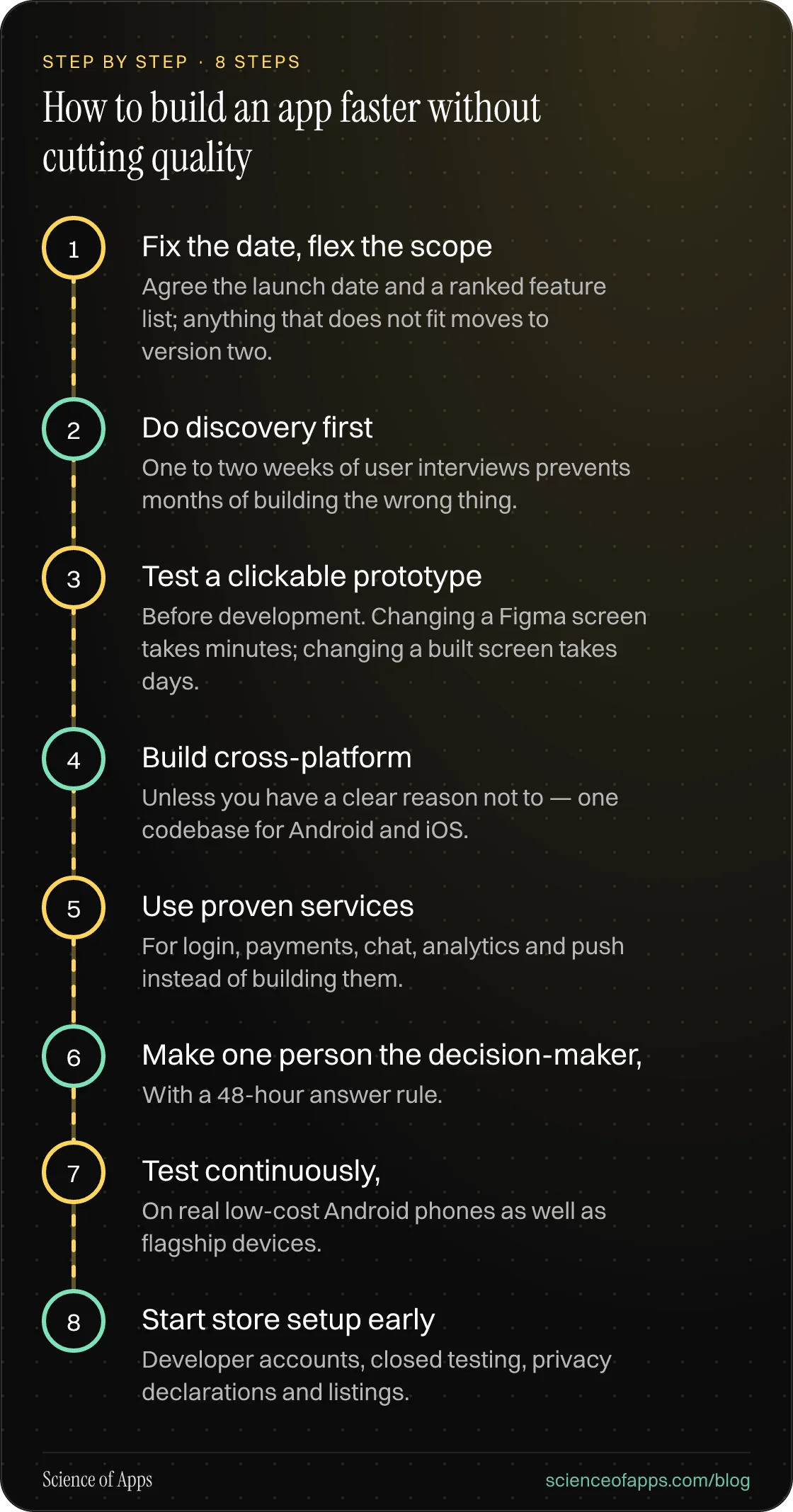

Diagram of 8 steps for how to build an app faster without cutting quality: 1. Fix the date, flex the scope; 2. Do discovery first; 3. Test a clickable prototype; 4. Build cross-platform; 5. Use proven services; 6. Make one person the decision-maker,; 7. Test continuously,; 8. Start store setup early
How to build an app faster without cutting quality
  1. Fix the date, flex the scope. Agree the launch date and a ranked feature list; anything that does not fit moves to version two.
  2. Do discovery first. One to two weeks of user interviews prevents months of building the wrong thing.
  3. Test a clickable prototype before development. Changing a Figma screen takes minutes; changing a built screen takes days.
  4. Build cross-platform unless you have a clear reason not to — one codebase for Android and iOS.
  5. Use proven services for login, payments, chat, analytics and push instead of building them.
  6. Make one person the decision-maker, with a 48-hour answer rule.
  7. Test continuously, on real low-cost Android phones as well as flagship devices.
  8. Start store setup early — developer accounts, closed testing, privacy declarations and listings.

Realistic week-by-week plan for a 12-week MVP

A realistic 12-week MVP plan
WeeksMilestone
1–2Discovery interviews, scope and success metric agreed
2–4Wireframes, prototype, usability test, visual design
4–10Development in two-week sprints with a demo at the end of each
8Closed testing starts on Google Play with 12+ testers
10–11Bug fixing, performance, store listings and privacy forms
11–12Store submission, staged rollout, analytics checked

How we estimated these numbers

The timelines are Science of Apps editorial estimates for a first version built by an Indian agency or experienced freelance team, consistent with our app development cost guide. Store timings come from Apple1 and Google's own documentation23. We review them every six months.

Key terms, defined

MVP — the smallest version of a product that delivers its core value to real users. Sprint — a fixed work period, usually two weeks, ending in a demo. Closed testing — a Google Play track that shares a build with a chosen group of testers before public release. Staged rollout — releasing an update to a percentage of users first. Scope creep — uncontrolled additions to a project after it starts.

Frequently asked questions

How long does it take to build an app?

About 6–10 weeks for a simple app or MVP, 3–6 months for most first versions of a real product, and 6–12 months for complex apps such as marketplaces, on-demand services, fintech and health apps. Add one to two weeks for app store review and Google Play's testing requirements for new accounts.

How long does it take to build an MVP?

A focused MVP — one core job, 5–10 screens, built cross-platform — takes 6–12 weeks including design and testing. If yours is heading past three months, the scope is probably no longer minimal.

How long does App Store approval take?

Apple says App Review typically reviews at least 50% of submissions within 24 hours and 90% within 48 hours. Rejections add time while you fix and resubmit, so submit a week before any launch date you have announced.

How long does Google Play approval take?

Google says processing can take a few hours or up to seven days, longer in exceptional cases, and recommends a buffer of at least a week before going live. New personal developer accounts must also run a closed test with at least 12 testers for 14 continuous days before applying for production access.

Why do app projects take longer than planned?

Mostly because the scope changes during the build, decisions wait on busy founders, designs are approved late, third-party integrations take longer than expected, and testing starts too late. Hiring more developers mid-project rarely helps; reducing scope does.

Can an app be built in a month?

A narrow prototype or a no-code app can be built in a month, and AI coding tools make simple apps faster still. A production app that handles real users, payments, edge cases and store review in a month is rare — and usually means something important was skipped.

Sources

  1. Apple Developer — App Review (review times)
  2. Google Play Console Help — Control when app changes are reviewed and published
  3. Google Play Console Help — App testing requirements for new personal developer accounts
  4. Wikipedia — Brooks's law (The Mythical Man-Month, 1975)
  5. Checked October 23, 2026. Figures that change — fees, salaries, prices — are reviewed every six months; if something is out of date, tell us.
Pass it on

Know someone who'd enjoy this?

Send it to them — one tap, no sign-up. Good ideas travel best between friends.

Keep exploring

Where to go from here

Join free

Get the ideas, not the noise.

Sign up with Google and we’ll send you short UX psychology tips by email — why people tap, stall and leave, and what to do about it. Unsubscribe anytime. Prefer something to keep? Get the free Laws of UX guide as a PDF.

Get the free Laws of UX PDFFree · no spam · unsubscribe anytime
Before you build

Spend your budget on what users want.

A behavioral UX audit of your app or SaaS product: why users hesitate, stall and leave, and a prioritized fix list. Fixed price, 2–4 weeks.

Free certification

Turn what you know into a credential.

Free, test-based UX, UI and product certifications. Answer real product scenarios, graded on our server, and earn a founder-signed certificate anyone can verify and you can add to LinkedIn.

  • Credential ID
  • QR verification
  • LinkedIn-ready
Free PDF · 74 pages · 2 editions

The Laws of UX, in one field guide

60 research-backed principles in 6 categories — what each one means, why it works on the human brain and how to use it on your own screens. Written by Sushant Singh, founder of Science of Apps, who has scaled consumer apps to lacs of users and spent 10+ years leading product across startups and digital businesses in the US, EU & India.

Pick your edition
Free. No card, no paywall — just your email.
Free PDF · 74 pages

Get Laws of UX by email

Choose your edition

You’ll also get occasional UX psychology tips. Unsubscribe anytime. Privacy policy

Free PDF · 90 pages · 2 editions

100+ Subscription Paywalls, decoded

110 real paywalls from top apps, taken apart, rated out of 5 and decoded with the Laws of UX — plus the frameworks, copy and checklists to ship your own. By Sushant Singh, founder of Science of Apps.

  • 110 paywalls rated
  • 34 Laws of UX
  • 12 frameworks

Which paywall scored 4.8 out of 5, and which scored 2.6? It’s all inside.

Pick your edition
Free. No card, no paywall — just your email.
Free PDF · 90 pages

Get 100+ Paywalls, Decoded by email

Choose your edition

You’ll also get occasional UX psychology tips. Unsubscribe anytime. Privacy policy
