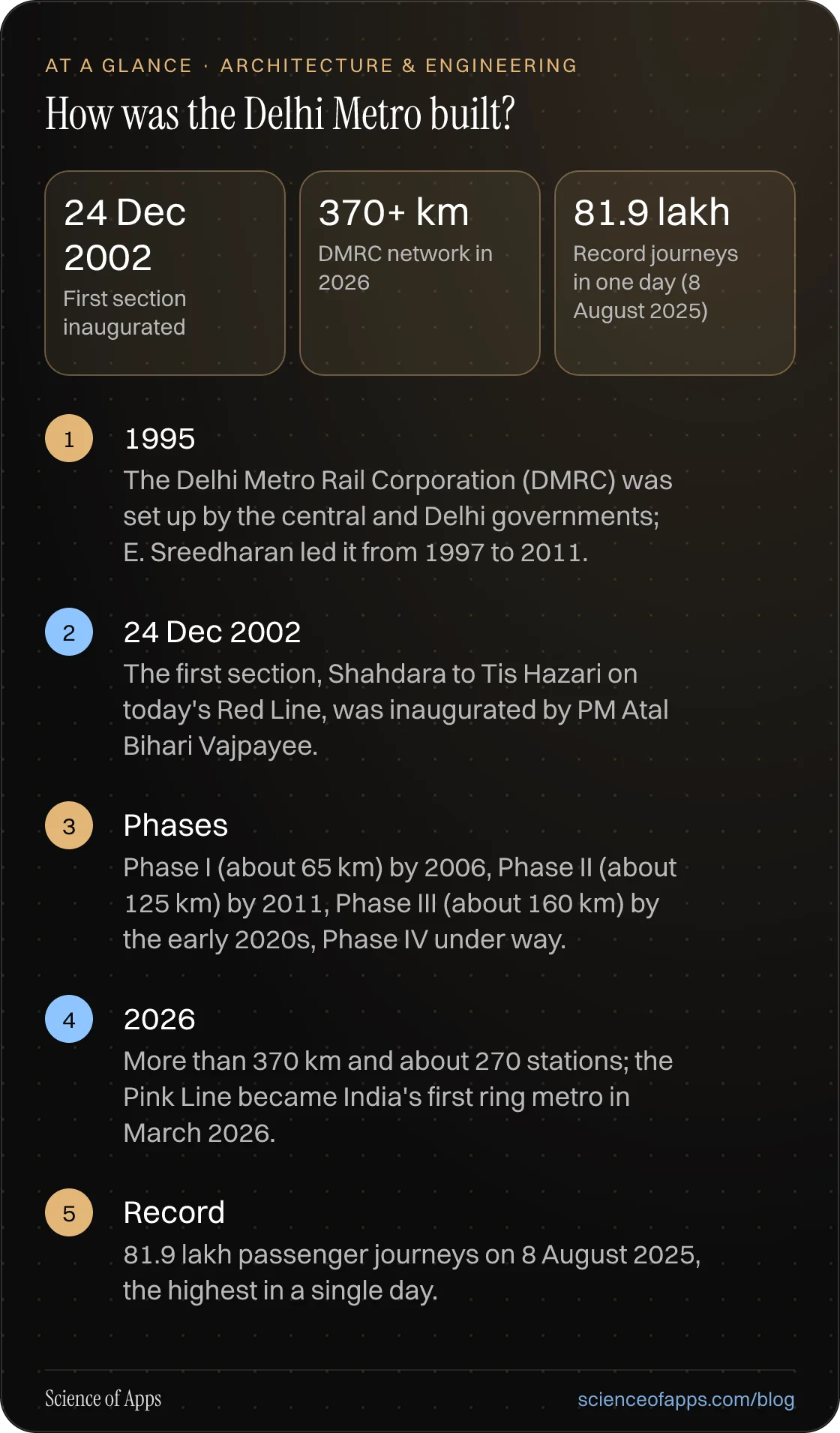

Quick answer: How was the Delhi Metro built?
- 1995 — the Delhi Metro Rail Corporation (DMRC) was set up by the central and Delhi governments; E. Sreedharan led it from 1997 to 2011.
- 24 Dec 2002 — the first section, Shahdara to Tis Hazari on today's Red Line, was inaugurated by PM Atal Bihari Vajpayee.
- Phases — Phase I (about 65 km) by 2006, Phase II (about 125 km) by 2011, Phase III (about 160 km) by the early 2020s, Phase IV under way.
- 2026 — more than 370 km and about 270 stations; the Pink Line became India's first ring metro in March 2026.
- Record — 81.9 lakh passenger journeys on 8 August 2025, the highest in a single day.
Key takeaways
- Delhi Metro's early success came from management as much as engineering: fixed deadlines, a small empowered corporation and public credibility.
- Most of the network is elevated, which is faster and cheaper to build than tunnels, with underground sections in the dense centre.
- Design choices such as automatic fare gates, platform doors on newer lines and women-only coaches shaped how Delhi travels.
- Regenerative braking made it the first rail project registered under the UN's Clean Development Mechanism, in 2007.
- Its Beck-style line map and colour coding made a complex network readable for millions of first-time metro users.
On Christmas Day 2002, crowds queued at Shahdara and Tis Hazari to ride a new kind of public transport. For many, it was their first ride on an escalator or through an automatic gate. The day before, Prime Minister Atal Bihari Vajpayee had inaugurated the first eight kilometres and, by DMRC's account, insisted on paying for his own ticket3. Twenty-four years later, the Delhi Metro is India's largest metro network, more than 370 kilometres long, and on its busiest day it has carried more than eight million journeys. This is how it was planned, built and designed.

Delhi Metro at a glance
| Milestone | Date | What happened |
|---|---|---|
| DMRC set up | 3 May 1995 | Joint venture of the central and Delhi governments |
| E. Sreedharan joins | 1997 | Managing director until 2011 |
| First section | 24 Dec 2002 | Shahdara–Tis Hazari, about 8 km, Red Line |
| Phase I complete | 2006 | About 65 km |
| Phase II complete | 2011 | About 125 km more, before and after the 2010 Commonwealth Games |
| Airport Express | Feb 2011 | High-speed line to Indira Gandhi International Airport |
| Driverless trains | 28 Dec 2020 | Magenta Line, India's first |
| Phase III complete | Early 2020s | About 160 km more, Pink and Magenta lines |
| India's first ring metro | 8 Mar 2026 | Pink Line loop completed in Phase IV |
| Ridership record | 8 Aug 2025 | 81.9 lakh journeys in one day |
Table: Delhi Metro milestones (DMRC, PIB and contemporary reporting)
- First section inaugurated
- 24 Dec 2002
- DMRC network in 2026
- 370+ km
- Record journeys in one day (8 August 2025)
- 81.9 lakh
- Train punctuality reported for 2026
- 99.95%
Why Delhi needed a metro
By the 1990s Delhi was choking. The city relied on buses and private vehicles, road traffic and pollution were rising fast, and earlier proposals for a mass rapid transit system had stalled for decades. In 1995 the Government of India and the Government of the National Capital Territory of Delhi set up the Delhi Metro Rail Corporation as a joint venture to build one1.
The decision that shaped everything else was choosing E. Sreedharan, a railway engineer who had delivered the difficult Konkan Railway along India's west coast, as managing director in 1997. Sreedharan ran DMRC as a small, autonomous organisation with fixed deadlines published in advance. Phase I opened sections ahead of schedule, which gave the project a public credibility rare for Indian infrastructure at the time3.

Phase I: the first 65 km (1998–2006)
Construction began in 1998, and on 24 December 2002 the first section, from Shahdara to Tis Hazari on today's Red Line, was inaugurated2. Phase I then added the underground Yellow Line through the old city and the business district of Connaught Place, and the Blue Line to the west and east, reaching about 65 km by 20064.
Phase I set the design pattern for the network: mostly elevated viaducts on single pillars in the road median, which are quicker and cheaper to build than tunnels, with underground sections only where the city was too dense, such as Chandni Chowk and Connaught Place. Early trains used India's broad gauge; later lines switched to the international standard gauge, which allowed lighter, off-the-shelf rolling stock.


Phase II and the Commonwealth Games (2006–2011)
Phase II was the great expansion: about 125 km of new line, roughly tripling the network, built largely in the run-up to the 2010 Commonwealth Games4. It extended the network across the Yamuna and into the satellite cities of Noida and Gurugram, and added the Airport Express line, opened in February 2011, with check-in facilities in the city.
The pace of construction was extraordinary for an Indian city. It also produced the project's darkest moment: in July 2009 a section of an under-construction viaduct collapsed at Zamrudpur, killing six workers. Sreedharan offered his resignation, which was not accepted, and DMRC tightened its safety reviews.
Phase III and IV: rings, driverless trains and India's first ring metro (2011–2026)
Phase III added about 160 km, including two new long lines that run around rather than into the centre: the Pink Line and the Magenta Line. These lines changed travel patterns by letting people cross the city without changing in the crowded core. On 28 December 2020, the Magenta Line began India's first driverless train operations, using communication-based train control.
Phase IV, approved in 2019, is extending these lines. On 8 March 2026, new sections opened on the Magenta Line and the Pink Line, completing the Pink Line as India's first ring metro1. With these openings, the DMRC network passed 370 km.


The design decisions that shaped how Delhi travels
The Delhi Metro was designed not only to move trains but to introduce millions of people to a new way of travelling. Several design decisions did that work.

A readable map
DMRC adopted a Beck-style diagram with one colour per line and clear interchange symbols, the approach London pioneered in 1933 (see our Tube map history). Lines are named by colour, which works across languages.
Tokens and cards
Automatic fare gates with reusable plastic RFID tokens and smart cards made entry fast and fare evasion rare; QR tickets and phone-based tickets followed.
Women-only coaches
The first coach of each train has been reserved for women since 2010, a design response to safety concerns that became one of the system's most valued features.
Platform doors on new lines
Newer stations, especially on the driverless lines, have platform screen doors, which prevent falls and allow automatic operation.


Engineering that pays back: regenerative braking
When a Delhi Metro train brakes, its electric motors work as generators and feed electricity back into the overhead line for other trains to use. In 2007 this made DMRC the first rail project in the world registered under the United Nations' Clean Development Mechanism to earn carbon credits, for its regenerative braking56. The system, supplied with trains by Bombardier, cut the energy needed to run the trains substantially.
Ridership: how many people use the Delhi Metro?
Ridership has grown with the network. DMRC's previous record of 78.67 lakh journeys on 18 November 20247 was broken on 8 August 2025, the eve of Raksha Bandhan, with 81,87,674 passenger journeys in a day. In 2026 DMRC reported average daily ridership of about 64 lakh journeys and 99.95% train punctuality8.

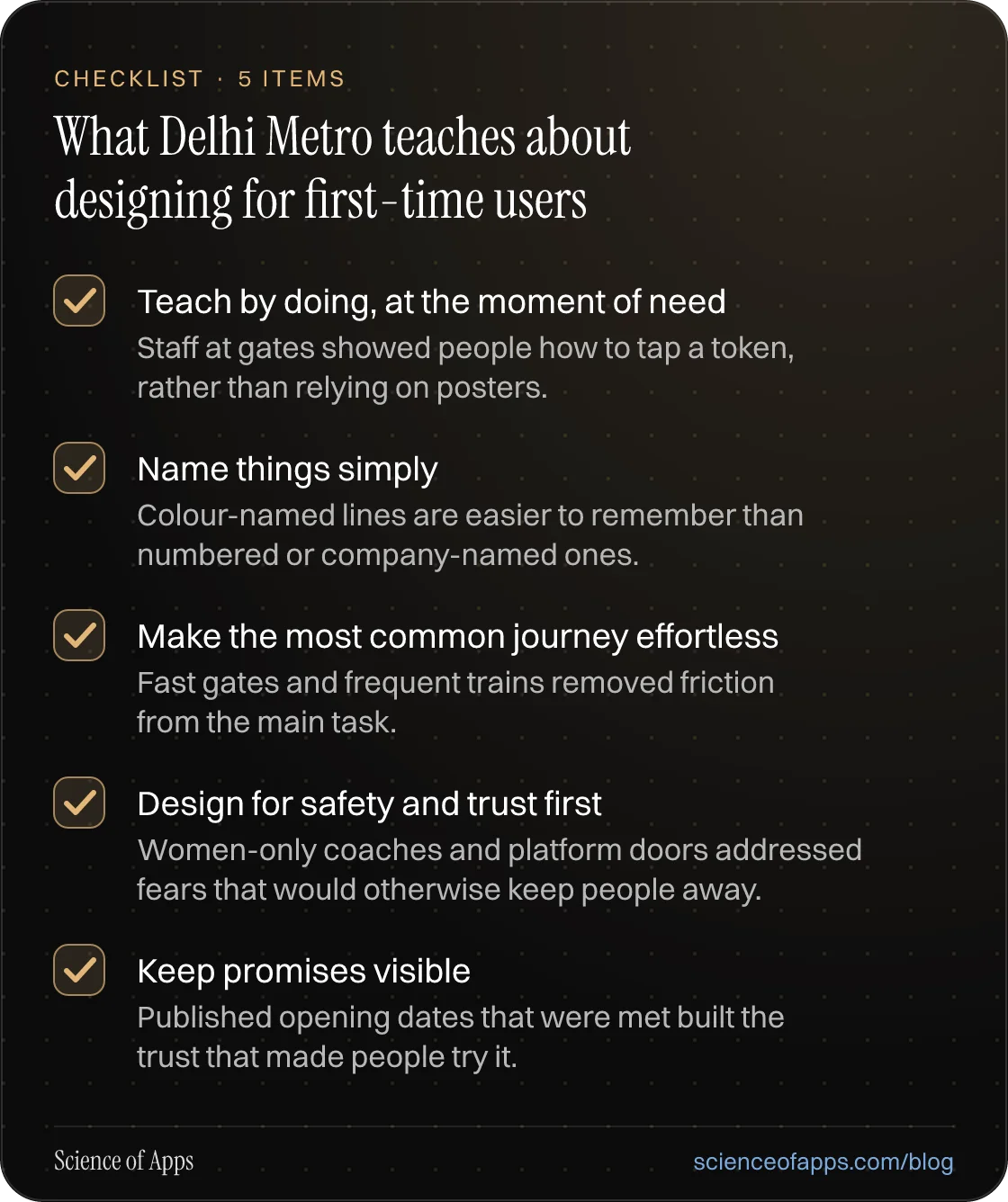

What Delhi Metro teaches about designing for first-time users
Many of the Delhi Metro's first passengers had never used a metro, an escalator or an automatic gate. Designing for them is the same problem every app faces with first-time users.

- Teach by doing, at the moment of need — staff at gates showed people how to tap a token, rather than relying on posters.
- Name things simply — colour-named lines are easier to remember than numbered or company-named ones.
- Make the most common journey effortless — fast gates and frequent trains removed friction from the main task.
- Design for safety and trust first — women-only coaches and platform doors addressed fears that would otherwise keep people away.
- Keep promises visible — published opening dates that were met built the trust that made people try it.
These are the same principles we look at in an onboarding audit: where new users hesitate, and what would let them succeed the first time.
How we researched this
Dates come from DMRC, the Press Information Bureau and contemporary reporting; phase lengths from published project summaries, which differ slightly between sources, so they are given as approximations. Ridership and punctuality figures are DMRC's, as reported by PTI and The Tribune. The carbon-credit registration is from the UNFCCC's CDM records. Photographs are from Wikimedia Commons, credited under each. Last reviewed October 2026.
Frequently asked questions
When did the Delhi Metro start?
Prime Minister Atal Bihari Vajpayee inaugurated the first section, from Shahdara to Tis Hazari on what is now the Red Line, on 24 December 2002. It opened to the public the next day. The stretch was about 8 km long; official and press sources give figures between 8.2 and 8.4 km.
Who built the Delhi Metro?
The Delhi Metro Rail Corporation (DMRC), a joint venture of the Government of India and the Government of the National Capital Territory of Delhi, set up in 1995. E. Sreedharan, a railway engineer known for the Konkan Railway, was its managing director from 1997 to 2011 and is widely called India's 'Metro Man'.
How long is the Delhi Metro?
As of 2026 the DMRC network is more than 370 km long with about 270 stations across its colour-coded lines, after the first Phase IV sections opened. It is India's largest metro network. Some figures that include connected systems such as the Noida–Greater Noida Aqua Line are higher.
Which is the newest Delhi Metro line or section?
On 8 March 2026, Phase IV sections opened on the Magenta Line (Deepali Chowk to Majlis Park) and the Pink Line (Majlis Park to Maujpur–Babarpur), completing the Pink Line as India's first ring metro line. Further Phase IV sections are scheduled to open through 2026 and beyond.
What is the Delhi Metro's highest ridership?
The highest single-day ridership was 81,87,674 passenger journeys on 8 August 2025, the day before Raksha Bandhan, according to DMRC. The previous record was 78.67 lakh on 18 November 2024. Average daily ridership in 2026 is around 64 lakh journeys.
Is the Delhi Metro driverless?
Partly. On 28 December 2020 the Magenta Line began India's first driverless train operations, using a communication-based train control system, and the Pink Line followed. Older lines are operated by drivers.
Sources
- Delhi Metro Rail Corporation — About us
- Press Information Bureau — Prime Minister inaugurates Delhi Metro (24 December 2002)
- ThePrint — A well-planned and efficient Delhi Metro: tracing the 16-year journey of the capital's lifeline
- Railway Technology — Delhi Metro project
- UNFCCC CDM — Regenerative braking in rail systems, Delhi Metro (project registration)
- Mass Transit — Bombardier technologies help Delhi Metro achieve world first under UN climate initiative
- The Week / PTI — Delhi Metro records highest-ever daily ridership of 78.67 lakh (November 2024)
- The Tribune — Delhi Metro records 99.95% train punctuality in 2026, DMRC
- Checked October 25, 2026. Figures that change — fees, salaries, prices — are reviewed every six months; if something is out of date, tell us.
Where to go from here
- London Tube map history — the diagram style Delhi's map follows
- Best airports in the world — more wayfinding at scale
- Design historyWindows evolution: how every version from Windows 1.0 to Windows 11 was designed, and what testing changedWindows evolution from tiled Windows 1.0 (1985) to Windows 11: the Start button, XP's Bliss, Windows 8's missing Start and the tests behind each change.
- Design historyLogo evolution: how 20 famous logos changed, and why almost all of them got simplerLogo evolution of 20 brands from Coca-Cola (1886) to Air India (2023): who designed each, what changed, and the memory science behind simpler logos.
- Architecture & engineeringThe Seven Wonders of the World, ancient and new: who built them, how, and what is leftThe Seven Wonders of the World, ancient and new: who built each, when, how they were engineered, and why only the Great Pyramid of the first seven survives.
- Architecture & engineeringUNESCO World Heritage Sites in India: all 45, with a map, dates and what makes each one specialIndia has 45 UNESCO World Heritage Sites as of 2026, after Sarnath: 37 cultural, 7 natural, 1 mixed. All of them on one map, with dates and design notes.
- Architecture & engineeringThe best airports in the world in 2026, and the design science that makes them easy to useThe best airports in the world in 2026, led by Singapore Changi, and the design behind them: wayfinding, short walks, daylight and the psychology of waiting.
- Everyday design scienceWhy is the keyboard QWERTY? What the patents, telegraphs and typing data actually showKeyboards are QWERTY because of an 1870s typewriter, not a plan to slow typists. What patents, telegraph history and 136 million keystrokes reveal about it.
Get the ideas, not the noise.
Sign up with Google and we’ll send you short UX psychology tips by email — why people tap, stall and leave, and what to do about it. Unsubscribe anytime. Prefer something to keep? Get the free Laws of UX guide as a PDF.
Great structures guide people without signs. So can apps.
A behavioral UX audit of your app or SaaS product: why users hesitate, stall and leave, and a prioritized fix list. Fixed price, 2–4 weeks.
